In April of 2008 the Granite Bay Golf Club Maintenance Department embarked on a bunker renovation project which we can now say is complete, at least for the on course bunkers. The project was originally slated for completion in 2010 however capitol funding was delayed in 2009 which effected the projects conclusion. We are ecstatic to have this project behind us as it has been taxing at times to keep up with normal golf course maintenance tasks along with keeping up with our construction goals. We still have many plans to continue moving the property forward from the pruning and brush clearing work we have already started to installing cart path curbing, tee re-surfacing and continued irrigation system enhancements. However the job of renovating 67 bunkers with over 2 acres of surface area is larger in scope then any other golf course project on the horizon and I am sure everyone is glad that we are finished.

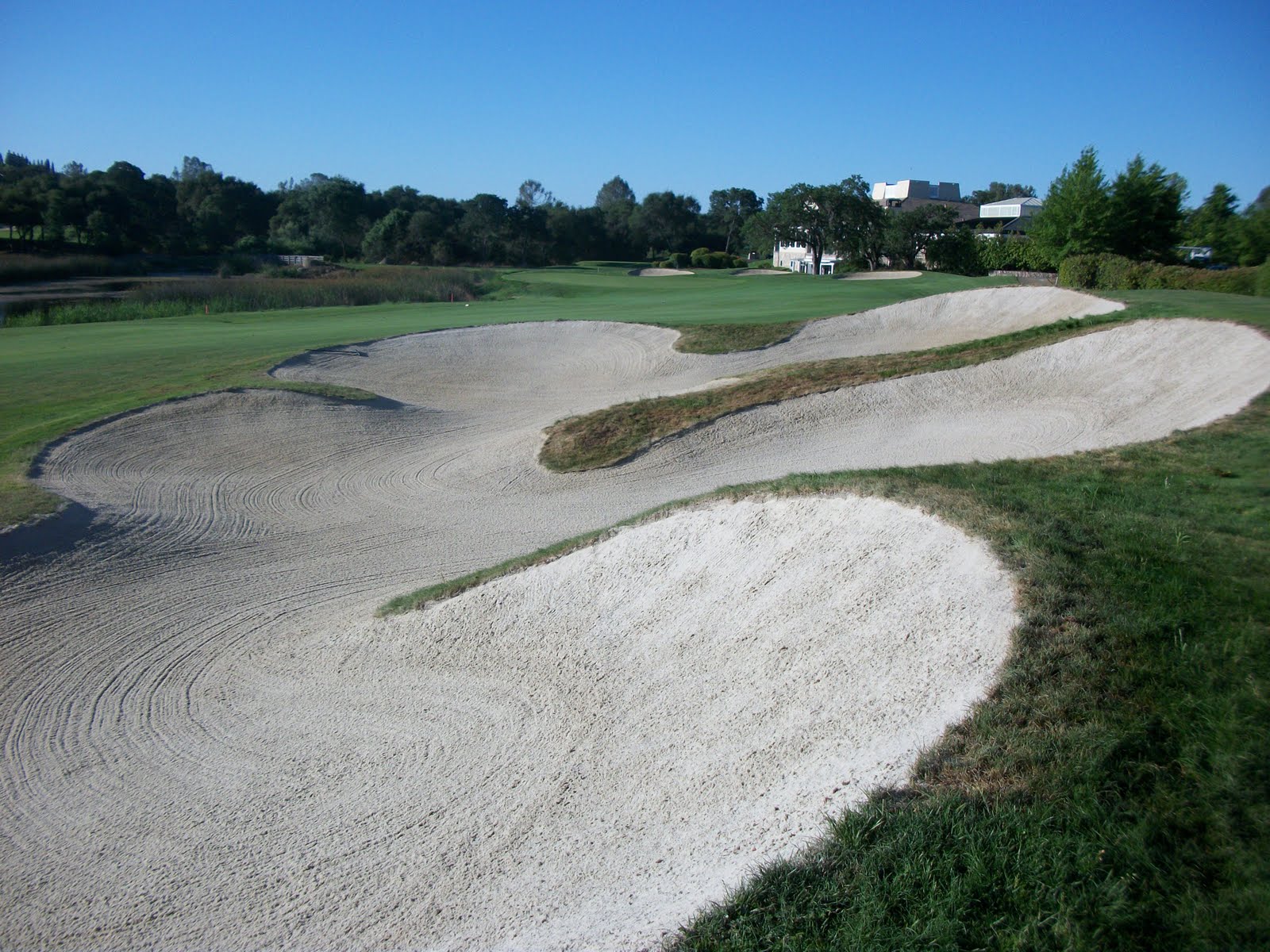

The last completed fairway bunker on #9. |
The "old" Granite Bay Bunkers were only 14 years old when we started the renovation process but had aged more rapidly then most due to some bad luck early in the life of the club. Granite Bay opened all 18 holes for play in December of 1994 which was directly proceeded by the 1995 La Nina storms which produced rainfall events of up to 5" in 24 hours. These storms washed the sand off the faces of the brand new bunkers and proceeded to erode the decomposed granite (DG) faces. This action moved native soil material onto the washed out sand in the bottom of the bunker mixing it with the sand and contaminating it. Maintenance crews attempted to remove the obvious top layer of emulsified DG from the bunker sand after the storms subsided but the weather patterns were persistent in contaminating the sand further after every event. Every subsequent winter storm that has washed out the bunkers since 1994 added to this contamination, producing bunker sand with very low percolation rates and a drainage system that was rendered ineffective from silt and fine sand and clay.
Winter storm November 2007 below #14 green |
Familiar sight in the winter prior to renovation. #15 greenside bunker November 2007. |

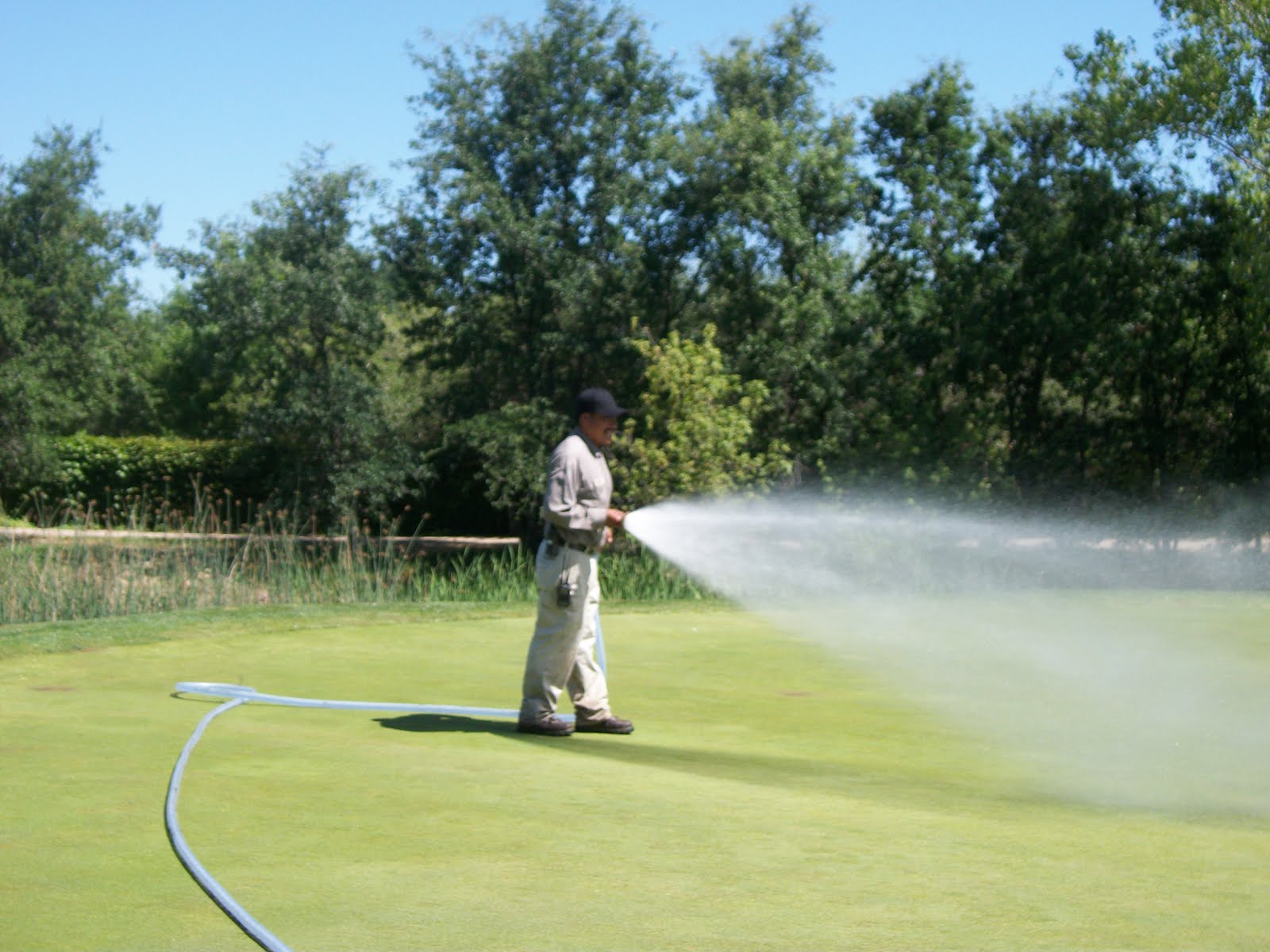

We realize that just because we have completed renovation and have replaced the drainage system and sand that our work is not done with these bunkers. Bunkers in general require allot of maintenance, particularly for a part of the course that is deemed a hazard. The almost constant moving of sand from the trap to the surrounding turf areas from players and maintenance equipment causes a structural change to these areas that requires diligent attention. Hand or mechanical raking, monitoring proper sand depths on faces versus bases, trimming, sod replacement, irrigation enhancements are a few of the necessary tasks to maintain the original vision of our bunkers and facilitate a fair test of golf. We already know just from last winters storms that with the new sand, drainage system and a bunker liner in place these traps don't hold water nor contaminate the new sand. This should result in our ability to devote the same amount of time to these bunkers as in years past yet achieve better results.
Traditional 4" drain pipe. Historically slows down and becomes almost ineffective over time. |
We realize that just because we have completed renovation and have replaced the drainage system and sand that our work is not done with these bunkers. Bunkers in general require allot of maintenance, particularly for a part of the course that is deemed a hazard. The almost constant moving of sand from the trap to the surrounding turf areas from players and maintenance equipment causes a structural change to these areas that requires diligent attention. Hand or mechanical raking, monitoring proper sand depths on faces versus bases, trimming, sod replacement, irrigation enhancements are a few of the necessary tasks to maintain the original vision of our bunkers and facilitate a fair test of golf. We already know just from last winters storms that with the new sand, drainage system and a bunker liner in place these traps don't hold water nor contaminate the new sand. This should result in our ability to devote the same amount of time to these bunkers as in years past yet achieve better results.
No Rest For The Weary
Practice Area Renovation Project Begins Monday July 25th
Practice Area Renovation Project Begins Monday July 25th
We plan to start working on the short game area starting next week. The end result is something I know many of you have been looking forward to for quite some time. My goal is to chronicle weekly or at least biweekly progress of this project via this course update. The push for starting and completing this project right now is twofold. First to provide durability I think the area should have at least a contingent of warm season turf in the way of hybrid bermuda and we are running out of time to get it propagated for this season. Secondly many of the member's who use the area are looking forward to a functional area to practice.

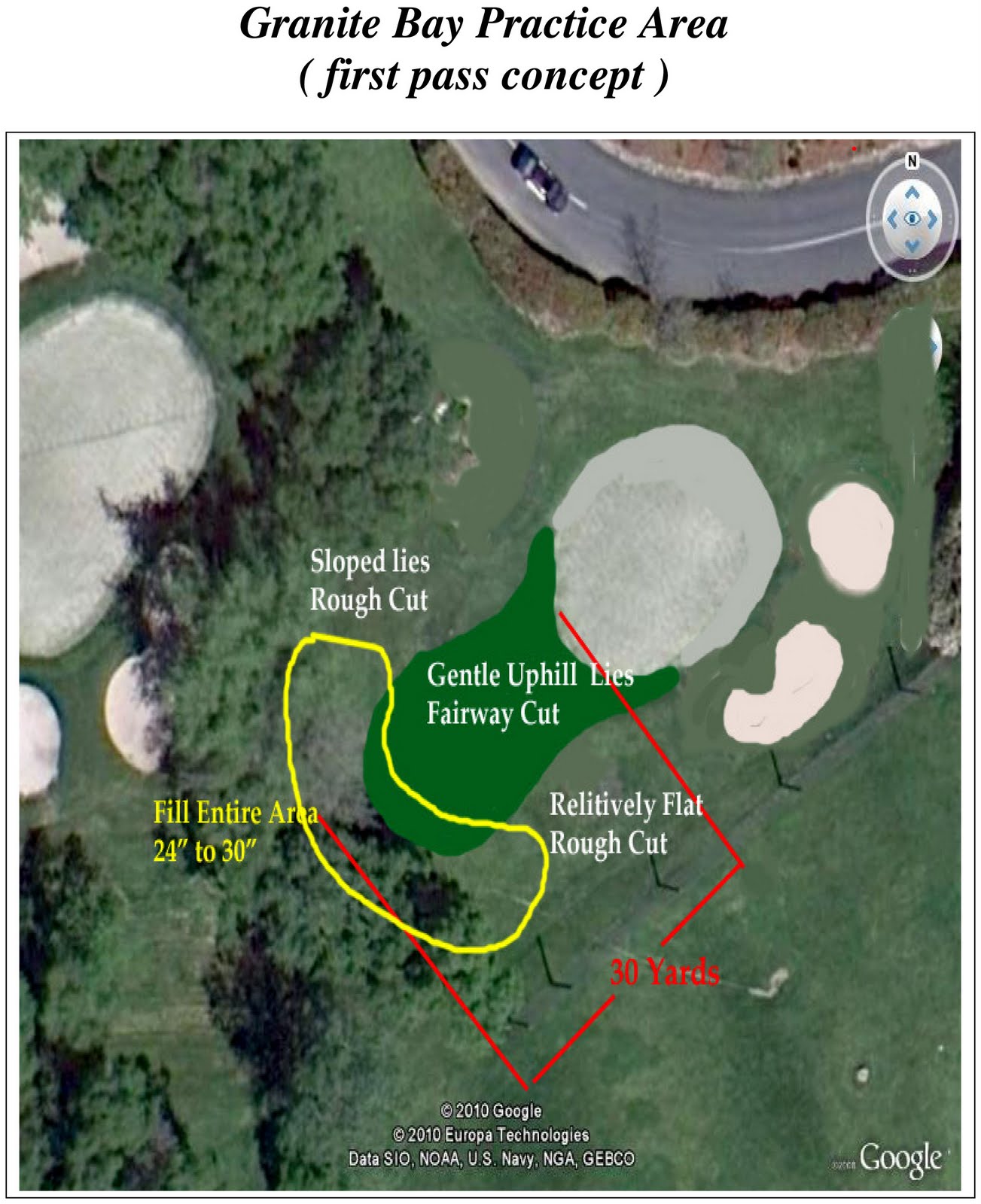

Creating this functional area is a bit of a challenge as we are limited by it's overall size. That being said the scope of work includes removal of the scraggly oak below the green and pruning two of the trees at the back of the area hopefully achieving at least a little expansion to the size of the area. Next we want to fill the entire lower area to create a more usable grade when chipping to the green. Additionally we plan to slightly expand the size of the green, remove the left hand bunker and make two bunkers out of the one bunker on the right. The project is the brainchild of our own Craig Johns who will be intricately involved in the "ongoing" design process.
Current view from below the short game area. Scrub Oak to be removed and fill to be brought in to soften / flatten the lies in front of the green. |
The following is an outline of construction goals and timing.
Week 1. 7/25 - 7/29 Tree trimming and removal. Identification and protection of irrigation heads. Removal of sod and transferring usable sod to #6 & #8 tees. Hauling of additional sand as fill. Start shaping of approach and surrounds.
Week 2-4. 8/1 - 8/19 Continued shaping of the area, expansion of the green, expansion of the irrigation system, re-shaping of the left hand bunker(s). (3 weeks)

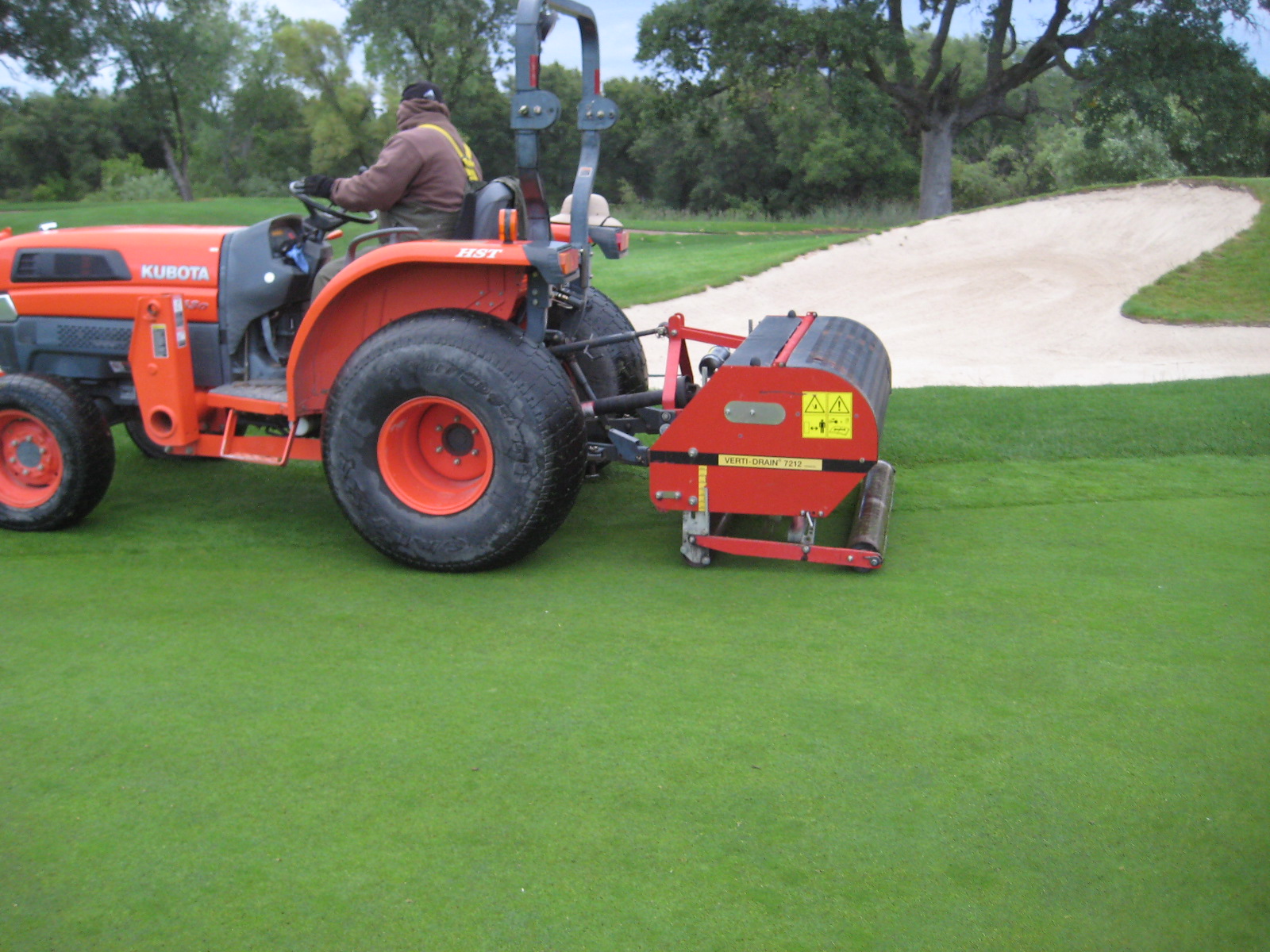

Week 5. 8/22 - 8/26 New sod around green and new bunkers. Install hybrid bermuda sprigs.
Week 6-9. 8/29 - 9/23 Grow in the warm season hybrid bermuda sprigs. (4 to 5 weeks)
Week 10. 9/26 - 9/30 Overseed with bluegrass & ryegrass.
Week 11-12. 10/3 - 10/14 Grow in cool season bluegrass & ryegrass. (3 to 4 weeks)
Week 13. 10/10 Tentative Re-open
I do not anticipate being able to re-open the area sooner then early October, if anything I could seeing us re-opening later then the October 10th goal. We'll just have to see how it goes.
